Skip to main content

Overview

The Pipeline Waterfall chart answers one question: “Why did my pipeline change?” It compares your open pipeline at two points in time, classifies each deal based on what happened between those points, and shows the net dollar impact of each type of change. The result always balances: your starting pipeline plus every gain minus every loss equals your ending pipeline. The chart is denominated in USD.

How to Read the Pipeline Waterfall Chart

Bars appear left to right in a fixed order. The first and last bars are gray and show your opening and closing pipeline totals. Everything in between explains the movement. Bar colors:
  • Gray - Start and End. Absolute totals, not changes.
  • Green - Deals that added to your pipeline:
    • Created (new deals)
    • Pulled In (existing deals that entered the window)
    • Amount Increased (deal values that went up)
  • Red - Deals that reduced your pipeline:
    • Amount Decreased (deal values that went down)
    • Pushed Out (anticipated close date moved outside the window)
    • Lost (closed lost)
    • Won (closed won - removed from open pipeline)
The chart balance:
Start + (Created + Pulled In + Amount Increased) - (Amount Decreased + Pushed Out + Lost + Won) = End

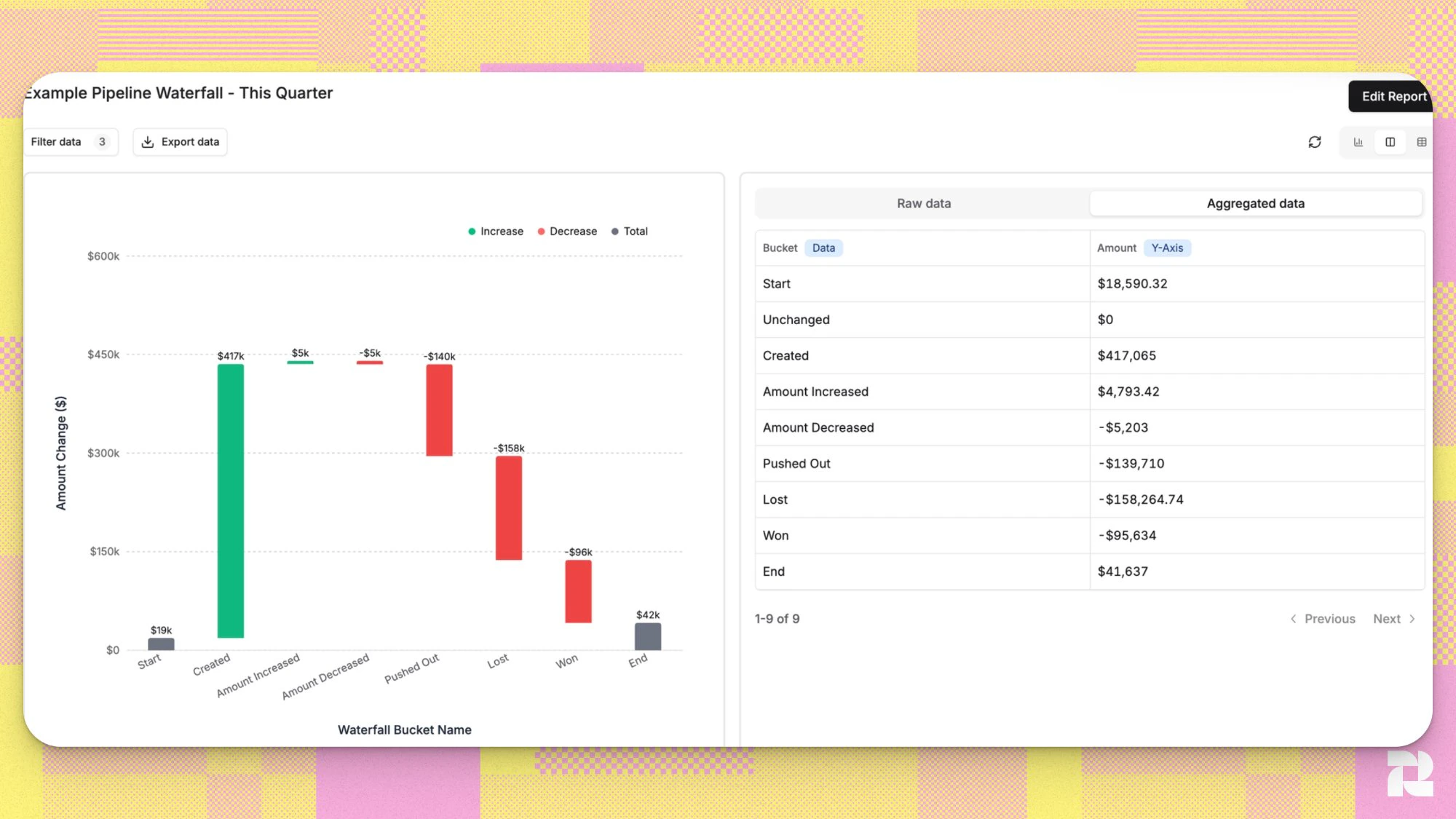

Data labels above each bar show the net dollar amount in compact format (e.g., $42k, $1.2M). Pipeline Waterfall chart example showing green increase bars and red decrease bars In the example above, the pipeline started at $19k, gained $422k from new deals and amount increases (+$417k created, +$5k increased), and lost $394k through pushed-out deals (-$140k), lost deals (-$158k), and closed-won deals (-$96k), ending the quarter at $42k.

Waterfall Buckets

The chart uses ten buckets. A deal can appear in more than one bucket when multiple things changed during the period - for example, a deal that was pulled into the window and then closed lost will appear in both Pulled In and Lost.
BucketWhat it meansBar colorAmount contribution
StartOpen deals with a close date inside the window at the start of the period. Your opening balance.Gray= Start Amount
UnchangedOpen deals in-window at both snapshots with no amount change. Contributes $0 - hidden from the chart, visible in table view only.None= 0
CreatedNew deals created during the period with a close date in the window.Green= End Amount
Pulled InExisting deals that were not in the starting pipeline but entered it during the period. Covers: close date moved into the window, deal reopened, or deal reopened then closed.Green= Start Amount
Amount IncreasedTracked deals whose net amount went up between the two snapshots.Green= End Amount - Start Amount
Amount DecreasedTracked deals whose net amount went down between the two snapshots.Red= End Amount - Start Amount (negative)
Pushed OutDeals whose close date moved outside the window and are still open at the end of the period.Red= -End Amount
LostDeals that became Closed Lost during the period and were relevant to the pipeline.Red= -End Amount
WonDeals that became Closed Won during the period. Won deals are removed from open pipeline.Red= -End Amount
EndOpen deals with a close date inside the window at the end of the period. Your closing balance.Gray= End Amount

The Two Time Filters

The Pipeline Waterfall requires two date filters that serve different purposes. Understanding both is essential before interpreting the chart. Snapshot Date answers: When did changes happen? This is your observation window. The lower boundary is the “before” snapshot; the upper boundary is the “after” snapshot. The chart reconstructs each deal’s stage, amount, and close date at each boundary using field history. Close Date Window answers: Which deals are we tracking? This defines the group of deals you care about, based on their anticipated close date. Only deals whose close date falls inside this range - at the start snapshot, the end snapshot, or at any point during the period - are included. Example:
  • Snapshot Date: March 1 - March 31
  • Close Date Window: Q2 2026 (April 1 - June 30)
This shows everything that happened during March to deals expected to close in Q2. A deal that moved its close date from April into July during March would appear in the Pushed Out bucket. Both filters default to This Quarter when you create a new report.

Step-by-Step Instructions

Creating a Pipeline Waterfall Report

  1. Go to Reporting.

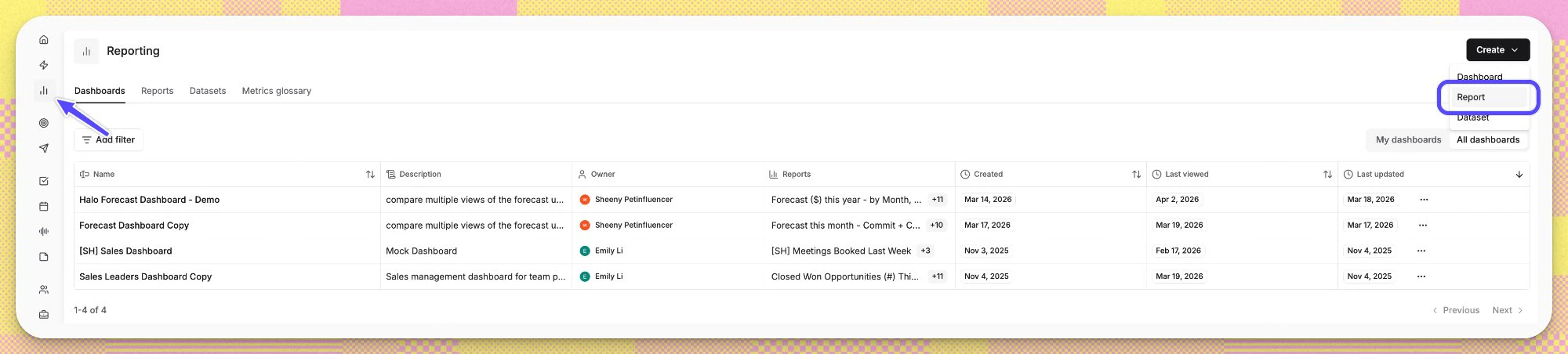

  2. Click Create - Report. Reporting page showing Create Report option
  3. Select Pipeline Waterfall as the chart type.

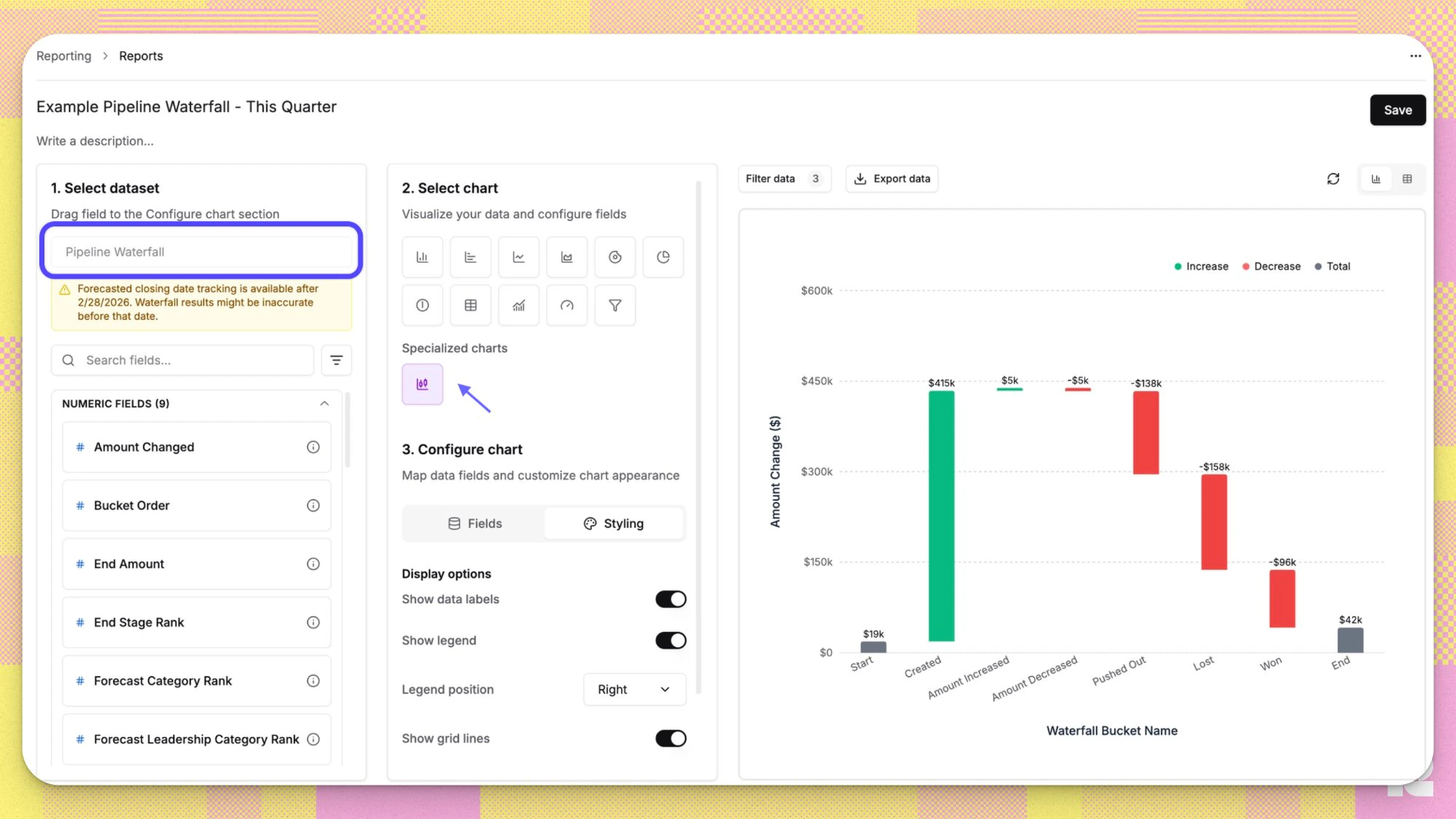

  4. The report opens with Snapshot Date and Close Date Window both set to This Quarter. Pipeline Waterfall chart type selected in the report builder
The waterfall chart shows the aggregated amounts with signs for each bucket, from positive (created, pulled in, amount increased) amounts on the left to negative amounts to the right.
For general report setup (saving, naming, adding to dashboards) see Building Reports from Datasets.

Adjusting Filters

  1. Click Filters - Add condition.
  2. Select Snapshot Date and set the period you want to analyze (e.g., last month, last quarter).
  3. Select Close Date Window and set the deals you want to track (e.g., this quarter, next quarter).

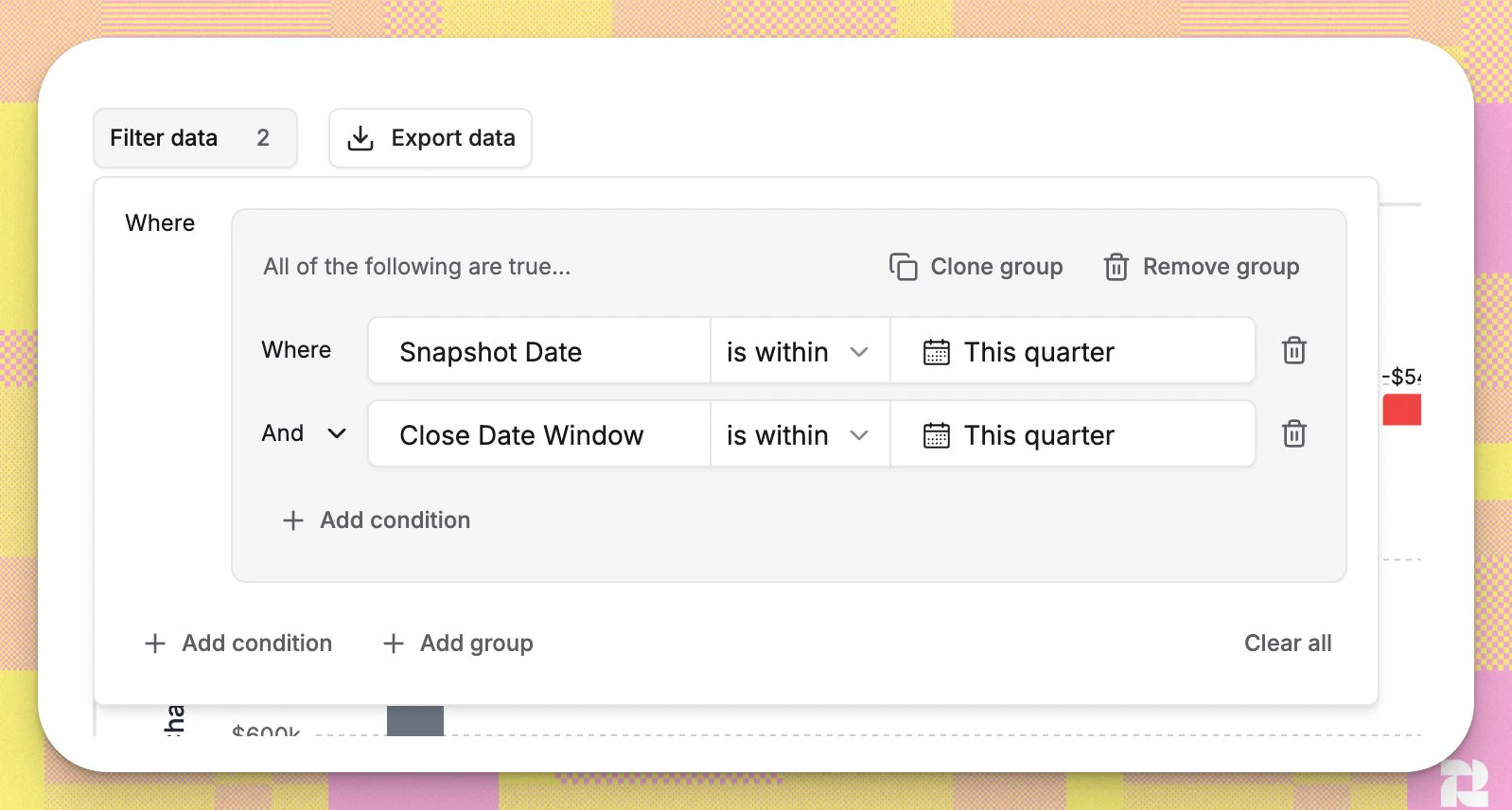

Filter panel showing Snapshot Date and Close Date Window both set to This Quarter

Optional Filters

FilterWhat it does
PipelineScope to a specific pipeline. When absent, uses the default pipeline.
OwnerFilter by the current opportunity owner.
Forecast CategoryFilter by the opportunity’s current rep forecast category.
Forecast Leadership CategoryFilter by the opportunity’s current leadership forecast category.
Stage Default Forecast CategoryFilter by the forecast category derived from the opportunity’s current stage.
OpportunityNarrow to a single specific opportunity.

Drilling Down Into a Bucket

There are two ways to further explore each bucket:

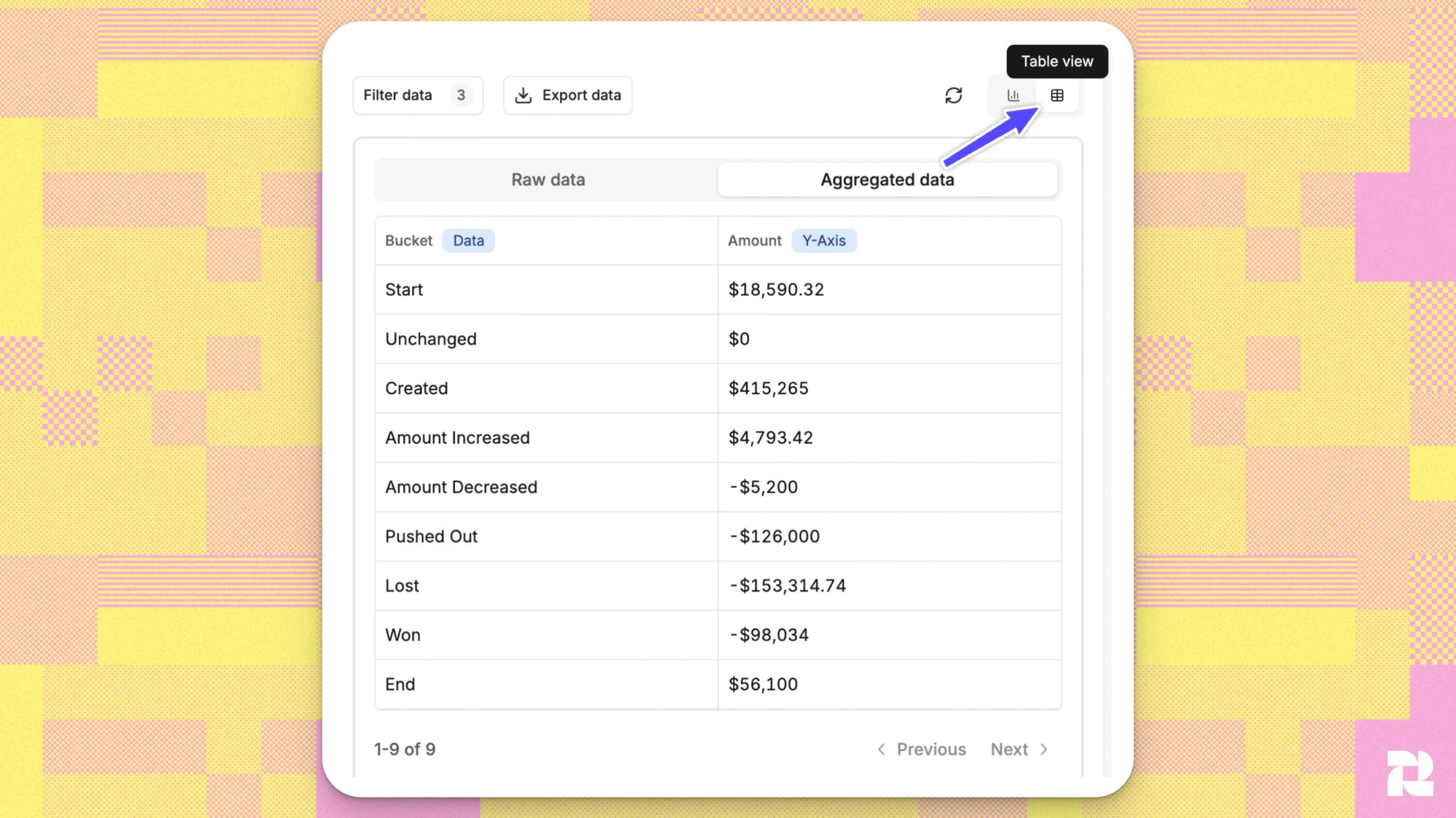

  1. To view aggregated data, select Table view in the top right corner. Table view showing aggregated amounts per bucket

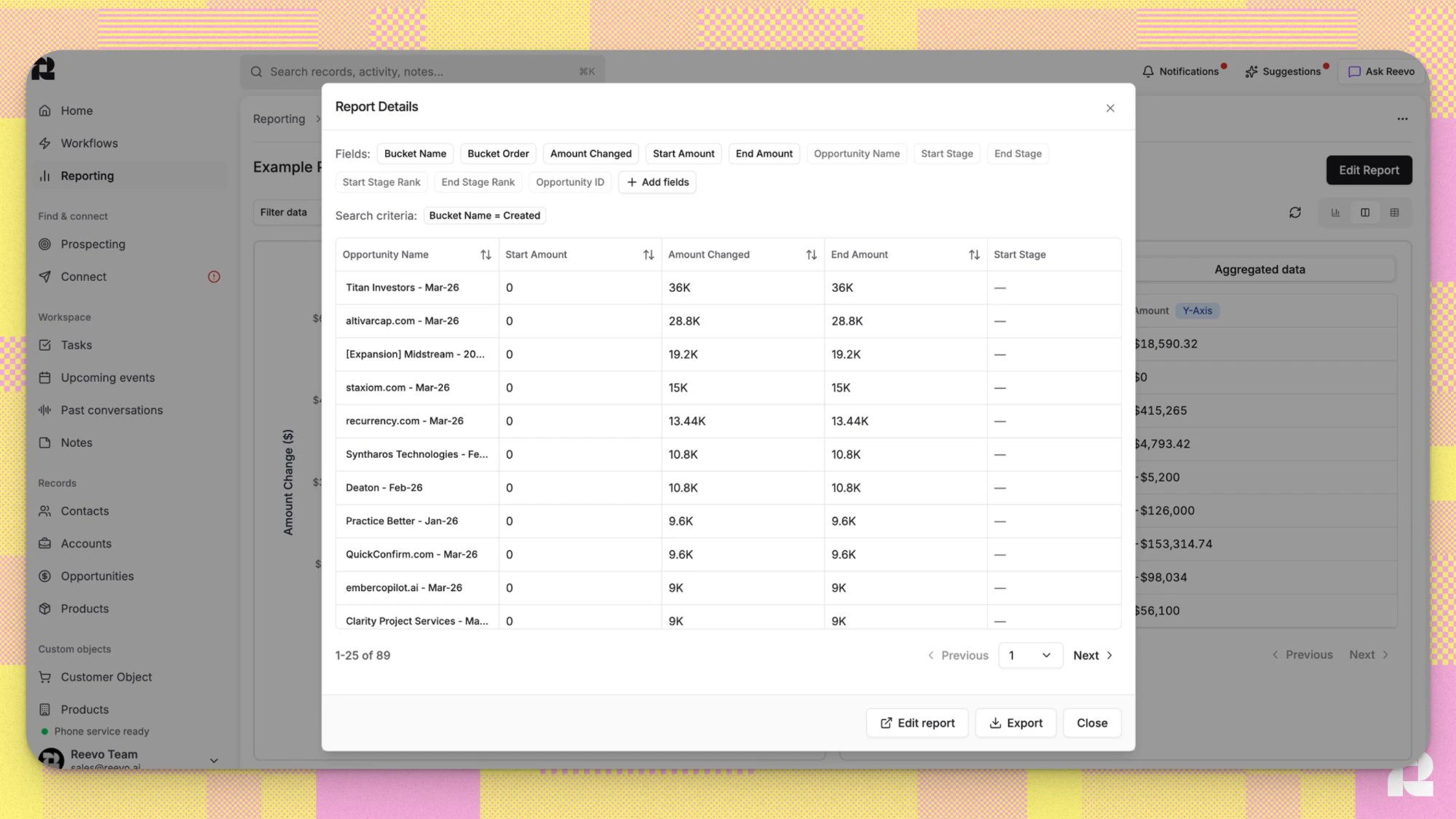

  2. To view what opportunities make up a bucket, hover over any bar and click. Each row is one opportunity. Click any column header to sort. Drill-through view showing individual opportunities in the Created bucket
These columns appear by default:
ColumnWhat it shows
Opportunity NameThe deal name
Start AmountThe deal’s amount at the start snapshot
Amount ChangedThe signed dollar contribution to the waterfall bar
End AmountThe deal’s amount at the end snapshot
Start StageThe deal’s stage at the start snapshot
End StageThe deal’s stage at the end snapshot
To add more columns, use Additional Fields in the report builder. How Amount Changed is calculated per bucket:
BucketAmount Changed
Start= Start Amount
Created= End Amount (Start Amount is 0 - deal did not exist yet)
Pulled In= Start Amount
Amount Increased= End Amount - Start Amount
Amount Decreased= End Amount - Start Amount (negative)
Pushed Out= -End Amount
Lost= -End Amount
Won= -End Amount
Unchanged= 0
End= End Amount

Styling Options

Under Styling in the report builder:
OptionDefaultWhat it does
Show data labelsOnDisplays compact USD amounts above each bar (e.g., $42k, $1.2M)
Show legendOnShows the Increase / Decrease / Total color key
Show gridOnHorizontal grid lines behind the bars
Show tooltipsOnHover a bar to see the exact dollar value

Troubleshooting / FAQ

Yes. A deal appears in every bucket that applies to it. For example, a deal that was pulled into the window and then closed lost during the same period appears in both Pulled In and Lost. The signed amounts are additive, so the waterfall balance still holds.
The chart shows net change only - the deal’s amount at the start snapshot compared to its amount at the end snapshot. Intermediate changes are not surfaced individually. For example: a deal that went $100k - $150k - $120k shows as Amount Increased with a +$20k delta.
Unchanged deals contribute $0, so there is no bar to render. Switch to Table view to see Unchanged deals and their deal count.
This happens when a deal’s close date entered the close date window mid-period rather than being in-window from the start. Because the deal was not part of the starting pipeline, it had no amount recorded at the start snapshot, so Start Amount is $0.
The Pipeline Waterfall chart type is pre-wired to the Pipeline Waterfall dataset. The bucket logic, signed amounts, and chart rendering depend on that dataset’s structure and cannot be decoupled from it.
